Lake Drive Improvements – Phase One

Compact Accessible Slideshow
Map of affected areas
Artist rendering depicting a car driving on the left side of the road and someone on a bike and two people walking on the right side.

Seasonal removal of the Lake Drive multi-use path begins Sept. 30

The Town will begin seasonal removal of the multi-use pathway along Lake Drive on Tuesday, Sept. 30, 2025. Work will move west to east from Civic Centre Road to South Drive. During this time, residents can expect temporary lane closures, brief delays, and should follow signage and directions from work crew personnel.

Schedule of Work:

  • Tuesday, Sept. 30, 2025, to Thursday, Oct. 2, 2025: removal of bollards and signs from Civic Centre Road to South Drive.
  • Thursday, Oct. 2, 2025: Removal of the traffic control island at South Drive.
  • Friday, Oct. 3, 2025: closure of the temporary emergency access route at Lagoon Drive and Metro Road, general clean-up and restoration activities.

Learn more about the schedule and what to expect.

Lake Drive Multi-Use Pathway

The Town implemented improvements to Lake Drive to enhance safety, support active transportation and maintain traffic flow. Following a planning study and public consultation in 2023, Council approved Phase One of the project.
Key changes include:
  • A seasonal one-way eastbound lane for vehicles and a seasonal separated multi-use pathway between Civic Centre Road and South Drive for pedestrians and cyclists
    This will be in place during high-traffic summer months, from June 26 at 7 a.m. to Oct. 3, 2025
  • Transition zones are situated at the east and west ends of the multi-use pathway to guide traffic safely
  • Permanent traffic calming measures have been added between Varney Road and Dalton Road, including stop signs, speed humps and pedestrian crossings
  • Drivers heading west between Civic Centre Road and South Drive should use Metro Road to get to their destination
  • A reminder that stopped vehicles are prohibited along Lake Drive all year long and may be subject to a parking ticket and/or be towed
These improvements aim to create a safer, more accessible Lake Drive for everyone.

Plan your visit

While exploring the area, enjoy the nearby beach spaces and take time to walk, cycle or drive into Jackson’s Point. Discover local shops, restaurants and attractions in the historic downtown.

Background

  • The Lake Drive Functional Assessment study was completed in 2023. This planning study included extensive public consultation, provided high-level analysis of design alternatives and made recommendations for the implementation. The planning study was the precursor to the current Lake Drive Improvements – Phase One project.
  • The objectives of the Phase One project include:
    • Seasonal (i.e. summer months) implementation of:
      • A multi-use pathway connecting North Gwillimbury Park to Dalton Road
      • Separated single lane, one-way vehicular traffic moving from west to east in the section from Metro Road/Varney Road to Dalton Road
      • Measures required to maintain timely access for emergency response vehicles
      • Transition zones at each end of the Phase One segment
      • Lane separators, signage and pavement markings to ensure clear directions for use of the road
      • Continued smooth traffic movement and access for operation and service vehicles
      • Traffic calming features as may be warranted
    • Conversion to two-lane, two-way vehicular traffic for the remainder of the year
  • In early summer 2024, Chisholm Fleming and Associates was awarded the engineering assignment for the project.
  • The main tasks included in the design phase of the engineering assignment include field investigations, preliminary design, stakeholder communications, detailed design and tendering.
    • As part of the preliminary design task, a communications plan will be developed and implemented to guide communications with key stakeholders.

Project update

May 2025

The construction phase of Lake Drive Improvements Phase One project has now begun.

The Town has engaged RS Construction Group as the contractor to complete the works. The contractor has mobilized and has begun work by laying out pavement markings. Over the next few weeks, more pavement markings, new crosswalks, new signs, speed humps, traffic control measures and lane separating bollards will be installed. The improvements are planned to be implemented prior to June 27, 2025 as scheduled.

Refer to notice of safety and active use improvements to Lake Drive East to learn more about the new features on Lake Drive.

April 2025

The engineering design of Lake Drive Improvements Phase One project is now complete. Construction will begin in May 2025.

Completed work

  • Detailed design including the tender-ready package
  • Provided an update report to the Council, which included more details about the project, established rough timelines on implementation and passed administrative bylaws (March 5 Council report)
  • Obtain all required permits (Lake Simcoe Region Conservation Authority and York Region) for construction
  • Select a contractor to undertake construction in a public and competitive procurement process

Next steps

  • Award the construction contract to the successful contractor
  • Conduct public education campaign through various measures and channels, including but not limited to the following:
    • Up-to-date webpage
    • Georgina Matters newsletter
    • Letters to residents in project area
    • Social media posts
    • On-street signage
    • Media release once multi-use pathway is fully implemented
  • Begin construction and fully implement improvements features prior to June 27, 2025

February 2025

The engineering design of phase one of the Lake Drive Improvements began in summer 2024 and is now nearing completion.

Completed work

  • Preliminary design
  • Targeted stakeholder group workshops and discussions (presentation slides)
  • Consultation with Lake Simcoe Region Conservation Authority (LSRCA)

 Next steps

  • Complete detailed design including the tender-ready package
  • Provide an update report to the Council in Q1 2025
  • Select a contractor to undertake construction
  • Conduct public education campaign through various measures and channels (e.g., webpage updates, letter to residents, social media posts, signage etc.)
  • Complete construction and fully implement improvements features for summer 2025

November 2024

The engineering design stage of phase one of the Lake Drive Improvements began in summer 2024.

The following briefly describes key aspects of the project:

Current status

  • The project kick-off meeting occurred in June 2024
  • Work has been completed on:
    • Background information collection and review
    • Site investigations
    • Communications Plan
    • Draft Preliminary Design
    • November 20, 2024 Council report providing an update on status
  • The following tasks are nearing completion:
    • Final Preliminary Design
    • Targeted stakeholder group discussions

Next steps

  • Roll out of the communications plan including:
    • Letters to residents, on-street signage, social media posts, etc.
  • Complete the detailed design design

Photos and videos

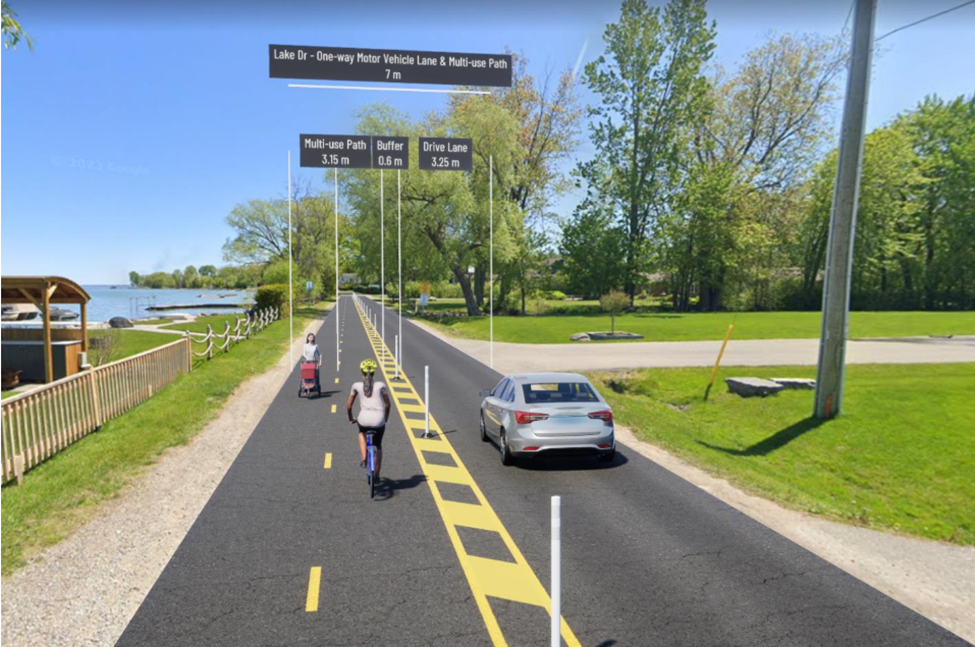

Conceptual rendering of multi-use pathway

Map of affected area

Map of affected areas

Timeline

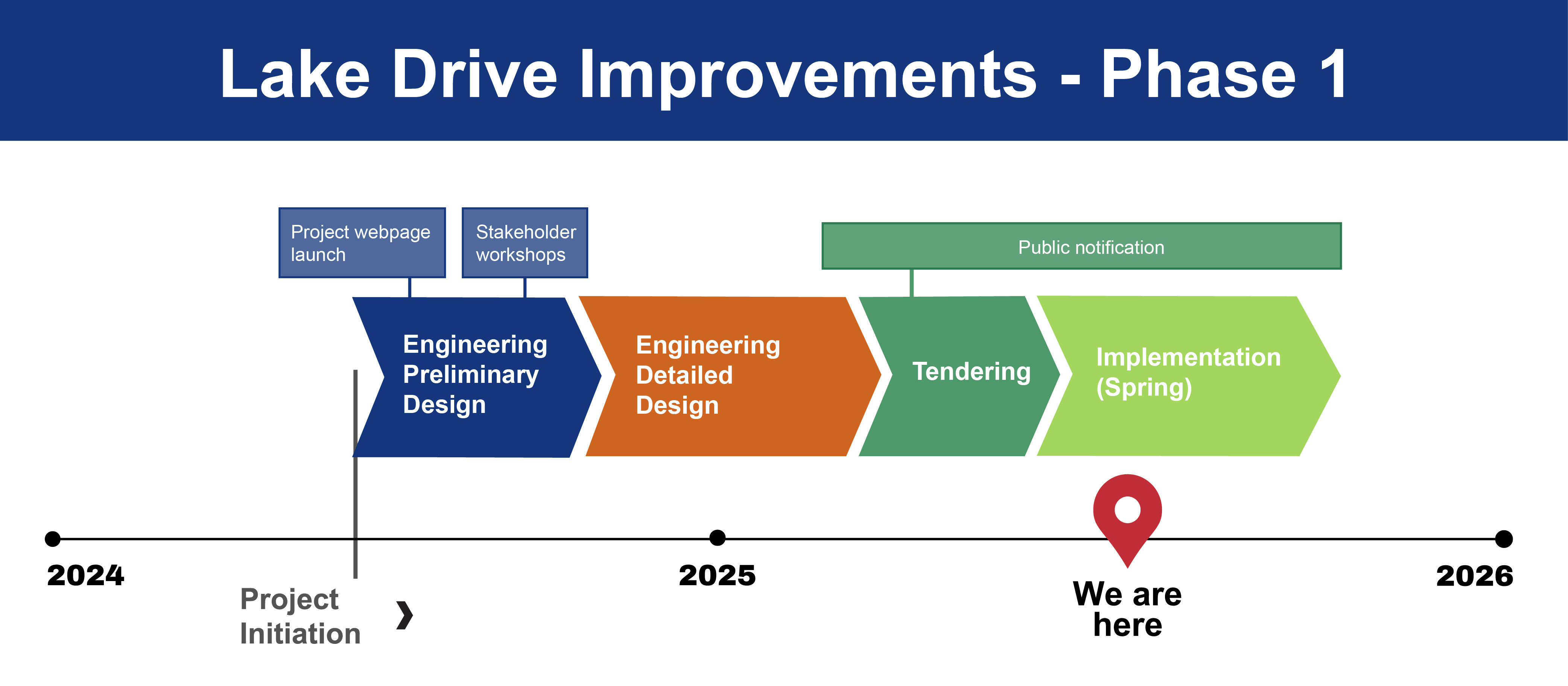

Timeline

2024

  • Project launched
  • Engineering preliminary design
  • Engineering detailed design

2025

  • Tendering and public notification
  • Implementation June 2025

Public engagement

The project will include the following public engagement activities:

  • Creation and posting of project-related information and regular updates to the Town-hosted project webpage and social media
  • Focused discussions with stakeholder groups
  • Distribution of letters/notices to local residents and businesses

Town contact

Owen Sanders, Senior Project Manager
osanders@georgina.ca
905-806-7470

Consultant

Paul LaPalme
Project Manager
paul.lapalme@chisholmfleming.com

Important Links

Lake Drive Functional Assessment

The Lake Drive Functional Assessment planning study was completed in 2023 an included extensive public consultation, high-level analysis of alternatives and recommendations for phasing and preferred concepts to be carried forward for design and implementation.

Lake-to-lake Cycling Route and Walking Trail

The Lake Drive Improvements – Phase one project encompasses a significant portion of the planned “Lake-to-lake Route,” which is intended to link Lake Ontario to Lake Simcoe.

Documents

Letter to residents

May 21, 2025 - Letter to Residents

May 4, 2025 - Letter to Residents

Frequently Asked Questions

Why is the Town undertaking the Lake Drive Improvements project?

Lake Drive is a unique and popular feature of the Town of Georgina because of its beautiful, natural setting following the shoreline of Lake Simcoe. Concerns have long been expressed that the narrow and curving roadway of many portions of Lake Drive poses problems for the mix of pedestrians, cyclists and motorists. The Town is taking action to improve the safety and utility of Lake Drive for all users, while amplifying the value of Lake Drive as a local asset.

When will this project be implemented?

Engineering design of Phase One is now complete. Construction work began in May 2025 with completion prior to June 27, 2025.



Will the improvements be permanent?

The one-way traffic and multi-use pathway was implemented over the summer months and Lake Drive returns to two-way traffic during the remainder of the year.

Which way will vehicle traffic drive?

Seasonal one-way vehicle traffic will travel west-to-east, from North Gwillimbury Park towards Dalton Road.

Are there any changes to public or emergency services in this area?

Yes. Emergency services, waste collection, school buses, and Canada Post have adjusted their routes to make sure services continue as usual.

Emergency and service vehicles (like those doing road work or tree trimming) are allowed to use the multi-use pathway when needed. This mitigates emergency response time impacts and allows regular maintenance to continue.

Emergency vehicles will be able to travel on Lake Drive East in these ways:

  • Eastbound in the regular vehicle lane (as usual)
  • Eastbound in the multi-use pathway lane (if needed)
  • Westbound in the multi-use pathway lane (if needed)
  • Westbound in the regular vehicle lane (if it’s safe)

Where are large groups of cyclists supposed to ride on the Lake Drive Multi-Use Pathway?

It is recommended that large groups of cyclists use the eastbound one-way street between Civic Centre Road and South Drive for vehicle traffic. The multi-use pathway is designated for pedestrians and passive cyclists.

How is this project related to the previous Lake Drive Functional Assessment Study?

The Lake Drive Functional Assessment Study occurred in 2023 and was a precursor to the current Lake Drive Improvements – Phase one project. The study provided the recommended phasing and preferred design alternatives to be implemented along Lake Drive South, Lake Drive North, Lake Drive East, and Hedge Road. The study also included extensive public consultation including:

  • Letters to residents
  • Webpage updates
  • Two virtual workshops
  • Beach pop-up sessions
  • Public Information Centre

The key takeaway from these public consultations was that the majority of feedback received was to implement a one-way road along a portion of Lake Drive, with the other lane being a bi-directional multi-use pathway.

How is this project related to the Waterfront Parks Master Plan?

This project is separate from the Waterfront Parks Master Plan, which has a long-term implementation horizon extending past 2030. The project teams coordinate and work together to achieve integration of planned activities between the two projects.

What are the key features to be implemented on Lake Drive during construction?

  • Multi-use pathway (north lane) and one-way west-to-east vehicle lane (south lane) between Civic Centre Road to South Drive
  • Sharrows (vehicles reminded to share the road with bicycles) between Varney Road and Civic Centre Road, and South Drive to Dalton Road
  • Bollard locations have been designed to avoid interference with regular vehicle access to driveways and connecting roads. If specific bollards interfere with movement of larger trailers or large delivery vehicles, bollards can be safely driven over in one direction. If you prefer not to drive over the bollard, provide advance notice to the Town. Town staff may temporarily remove and replace the bollard.
  • The improvements generally consist of pavement markings, signage installation, traffic calming (flex bollards, pedestrian crossing, speed humps installation), paving of asphalt shoulder and sidewalk installation
  • Six pedestrian crossings including speed humps at North Gwillimbury Park, Sheppard Wharf, Willow Beach, Willow Wharf, Franklin Beach and De La Salle Beach
  • Four new all-way stops at Woodbine Avenue, Civic Centre Road, Kennedy Road and South Drive
  • South Drive and Hardwood Drive traffic calming such as limited turning movements, speed cushions and local traffic only signage
  • Emergency-only access locations at Lagoon Drive and De La Salle Boulevard
  • Sidewalk extension at Eastern Transition Zone (around South Drive)

Refer to the schematic below for details

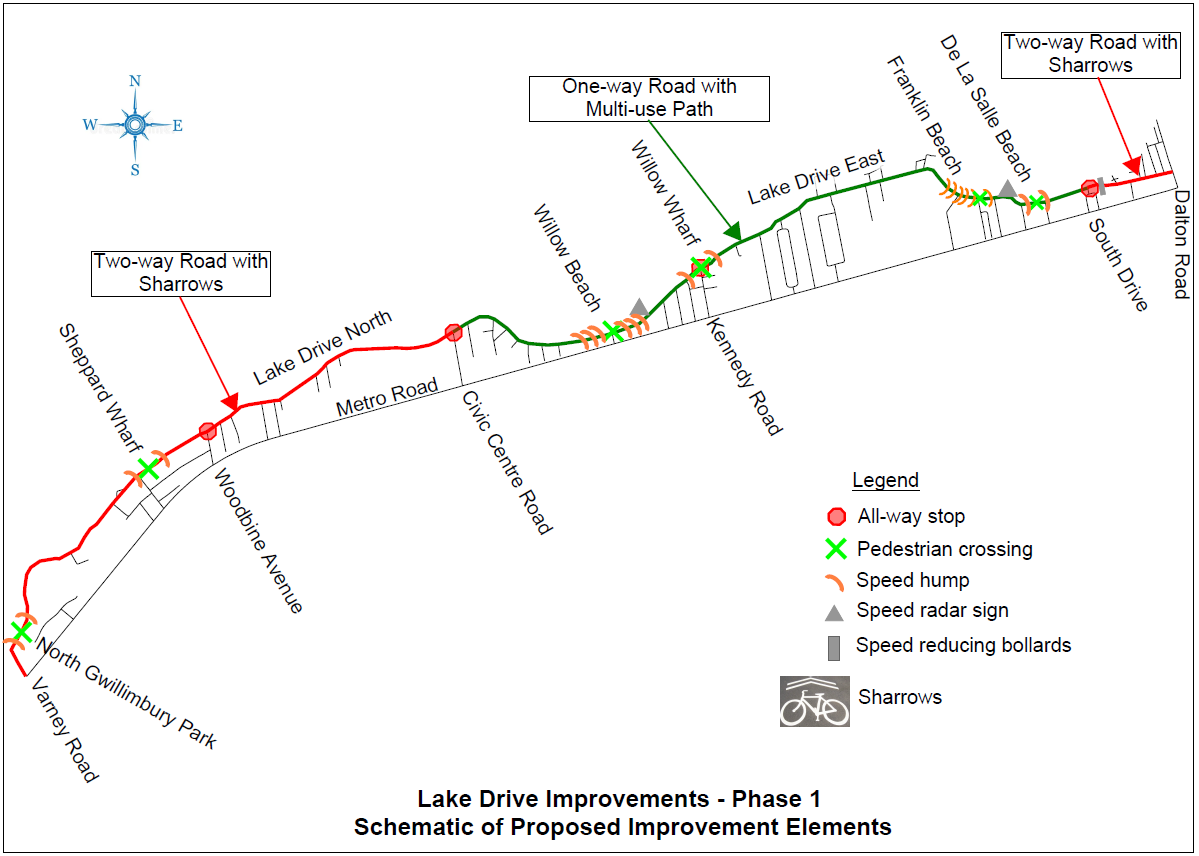

map of the affected area with areas highlighted as above

How long will these features be implemented in 2025?

The improvements were in place as of June 26, 2025, at 7 a.m. This configuration is seasonal and the MUP/one-way arrangement will be removed by Oct. 3, 2025.

How can one make the most of the new Lake Drive?

  • Use Lake Drive as the scenic and recreational jewel that it is. It’s a great place to slow down a little.
  • To save time, use Metro Road as a quicker alternative to Lake Drive.
  • Share the road. Pay attention, be careful and respectful of others using Lake Drive at all times.
  • Observe and obey all traffic and parking restrictions on Lake Drive and the surrounding streets. Restrictions will be enforced.
  • Remember to avoid turning west at Lake Drive and Dalton Road. Travel west along Metro Road instead.
  • Do not use South Drive or Hardwood Drive to access Lake Drive from Metro Road. These streets are now closed to northbound through traffic.
  • Do not drive through, park at or block designated “Emergency Access Only” entrances. These restrictions will be enforced.

Where can I park to access Lake Drive and nearby beaches?

Parking is not permitted along most of Lake Drive and nearby streets to ensure emergency access. However, public parking is available at:

  • Willow Beach
  • De La Salle Park

Visitors may use pay-and-display parking. Residents can use their parking passes. For full details on parking locations, fees and regulations, visit the Town of Georgina parking page.

Can cyclists use the mutli-use pathway?

Yes, passive cyclists can use the multi-use pathway along with pedestrians. Cyclists can also use the vehicle lane. In Ontario, cyclists are legally permitted to use a vehicle lane. Find out more about sharing the road at ontario.ca.

What are the rules for mobility scooters?

Mobility scooters are treated like pedestrians under the Highway Traffic Act, meaning they are allowed on the multi-use pathway.

Contact Us

26557 Civic Centre Rd,
Keswick, ON  L4P 3G1

T: 905-476-4301 / 705-437-2210
F: 905-476-8100
info@georgina.ca
